LAKELAND HOUSING INFRASTRUCTURE
DETAILED DESIGN
Location:
Lakeland
Scope:
This includes the following scope:
- Preliminary scoping.
- Detailed survey
- Geotechnical investigations
- Water and sewer modelling
- Flood modelling
- Ecological and cultural heritage surveys
- Detailed design of trunk infrastructure
- Water Treatment Plant (including raw and treated water storage)
- Trunk water pipeline infrastructure
- Sewerage Treatment Plant (including effluent disposal)
- Sewerage conveyance.
This project is funded under the Queensland Government’s Residential Activation Fund (Round 1)

18 July 2025 | NEWS Funding Secured to Plan for Growth in Lakeland
8 April 2026 | PUBLIC NOTICE Commenement of Survey & Investigation Works
Frequently Asked Questions
What is happening in Lakeland right now?
Council has engaged consultants to undertake survey and geotechnical investigations to inform the preliminary design of future water and sewer infrastructure.
What works will be carried out?
Works include:
- Surveying to measure ground levels
- Geotechnical investigations (such as drilling) to understand ground conditions
These activities are necessary to ensure infrastructure is designed appropriately.
When will these works take place?
Works are expected to commence from mid-April 2026 (weather permitting) and will occur over a short period.
Will consultants need to access my property?
Yes, in some cases short-term access to private property may be required for survey works. These works are non-destructive, and personnel will make reasonable efforts to notify residents where possible.
Will there be any disruption?
Minimal disruption is expected. Survey works are low impact, and geotechnical investigations will occur in public areas only.
Why is this project being undertaken?
This project supports future growth in Lakeland and is funded through the Residential Activation Fund to plan essential infrastructure such as water and sewer services.
Looking ahead (early-stage information)
What is the expected timeline for the project?
The project is currently in the investigation and preliminary design phase.
Subject to design outcomes and funding, construction timeframes are not yet confirmed. Council will keep the community informed as the project progresses.
Will I need to connect to the sewer network?
Properties within the future sewered area are expected to be required to connect, however details will be confirmed as the project progresses.
What will it cost to connect?
Connection costs will vary depending on individual properties.
Detailed information will be provided once design is further advanced.
Will there be ongoing costs?
Yes, ongoing charges are expected and would appear on rates notices.
Costs have not yet been determined.

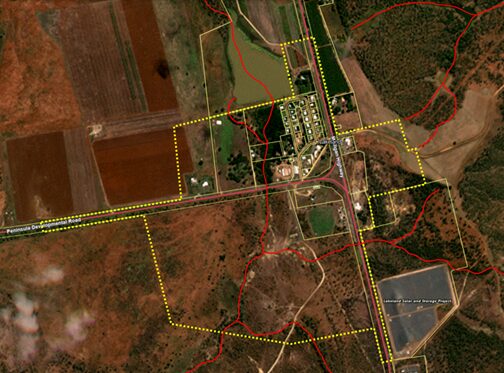

Where will the infrastructure be located?
Locations, including any treatment plant, are still being investigated. Updates will be provided once confirmed.
How will the community be kept informed?
Council will continue to share updates via the website, public notices, and community information sessions as the project progresses.
Timeline Phase 1: Detailed Design
February 2026
- Preliminary scoping
April 2026
- Water and sewer modelling
- Detailed survey
April/ May 2026
- Geotechnical investigations
May/June 2026
- Flood modelling and ecological surveys
July 2026
- Detailed design
July 2026
- Estimated date of completion
